Estimating and Tracking

You're all doing it wrong

Readings

  • These slides
  • The Agile Samurai: Chapters 7, 8, 9

The Problem

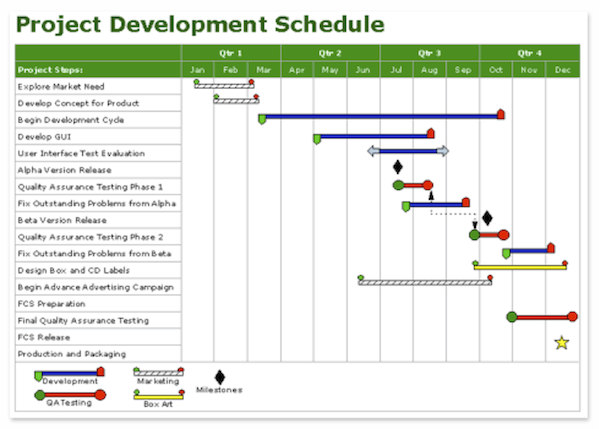

The Wrong Answer

http://www.total-quality-management-software.com/gantt-chart-examples.asp

Why Schedules Don't Work

Part 1: Estimation

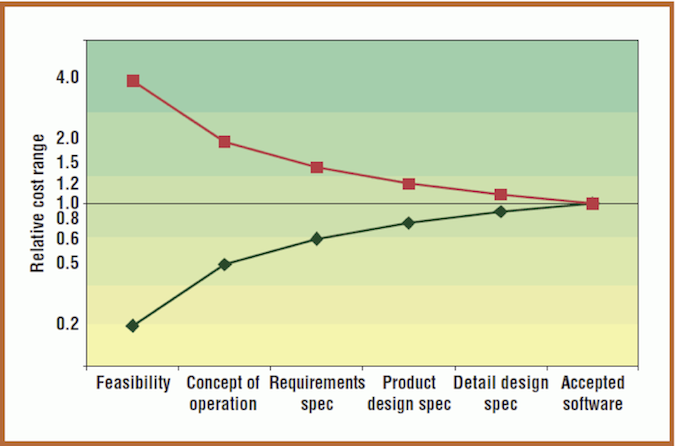

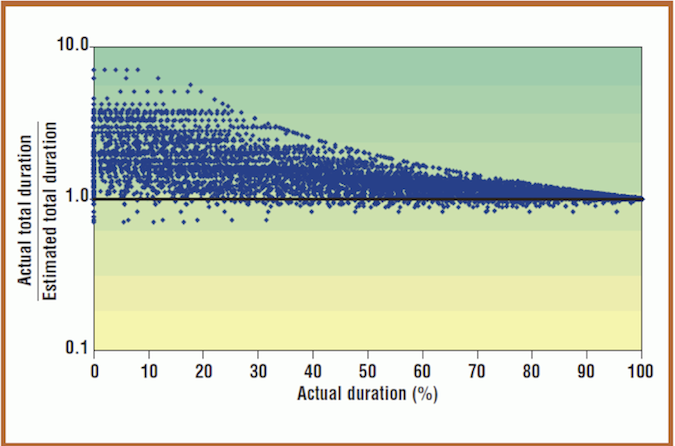

The Cone of Uncertainty

“Schedule Estimation and Uncertainty Surrounding the Cone of Uncertainty.” Todd Little. IEEE Software May/June 2006

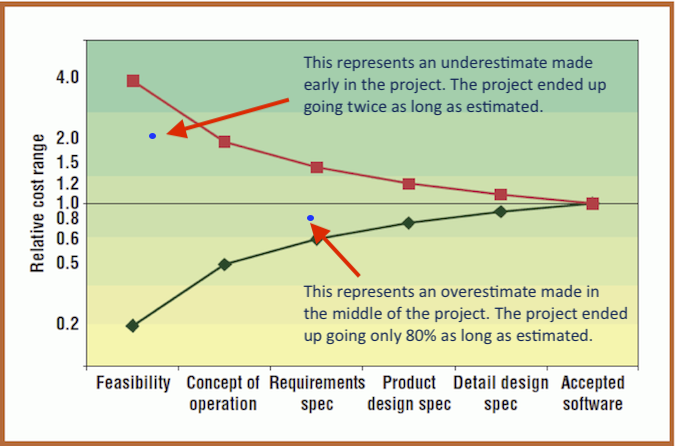

Cone Examples

“Schedule Estimation and Uncertainty Surrounding the Cone of Uncertainty.” Todd Little. IEEE Software May/June 2006

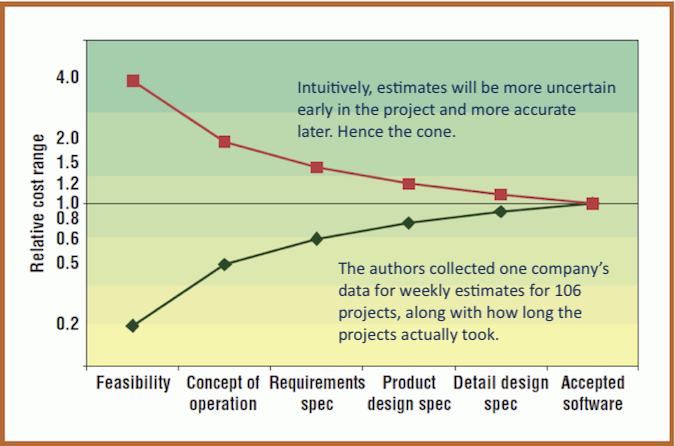

Cone Intuition

“Schedule Estimation and Uncertainty Surrounding the Cone of Uncertainty.” Todd Little. IEEE Software May/June 2006

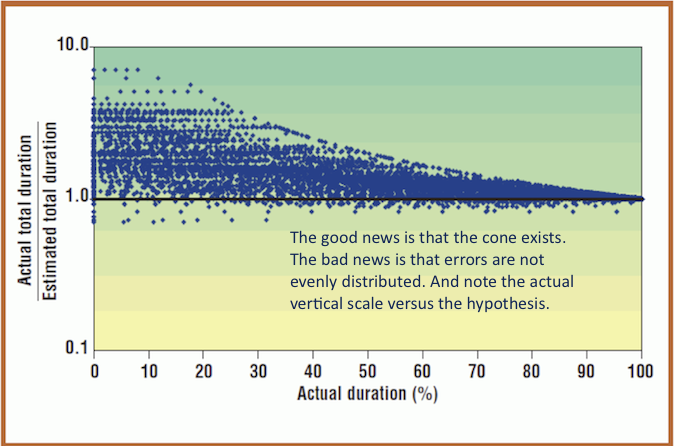

Cone Reality

“Schedule Estimation and Uncertainty Surrounding the Cone of Uncertainty.” Todd Little. IEEE Software May/June 2006

Cone Implications

“Schedule Estimation and Uncertainty Surrounding the Cone of Uncertainty.” Todd Little. IEEE Software May/June 2006

Why Estimates Don't Work

An estimate is the most optimistic prediction that has a non-zero probability of coming true. Tom DeMarco, Controlling Software Projects, Prentice Hall, 1982
  • If you can't trust programmer estimates of how long something will take, what can you do?

The Agile Alternative

Relative Estimates with Story Points

Story Points

  • A measure of relative effort
  • Points are not a measure of time
  • Points are not comparable between teams or projects

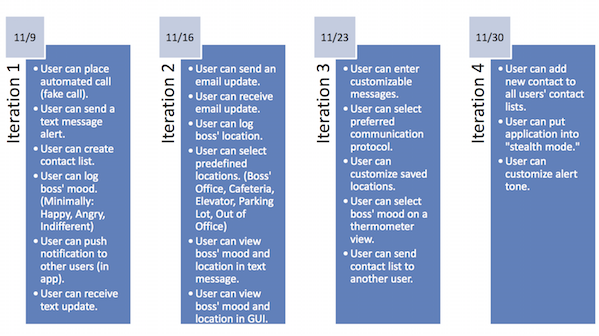

Step 1: Put all tasks on whiteboard

Step 2: Sort

  • Easiest to hardest, team consensus

Step 3: Assign points

  • Left to right, Fibonacci only, round up if necessary
  • A 2 + a 3 should be about a 5

Step 4: Add

  • 1 x 1 + 1 x 2 + 4 x 3 + 5 x 5 + 1 x 8 = 48
  • That total is how much work you have to do

Why Schedules Don't Work

Part 2: Schedules vs Reality

Lies, Damn Lies, and Schedules

Hallucinatory and Harmful

Lies My Schedule Told Me

  • "It's on the plan, so it will happen."
  • "Nothing was missed."
  • "No need to panic."
  • "If things slip a little, the developers can catch up."

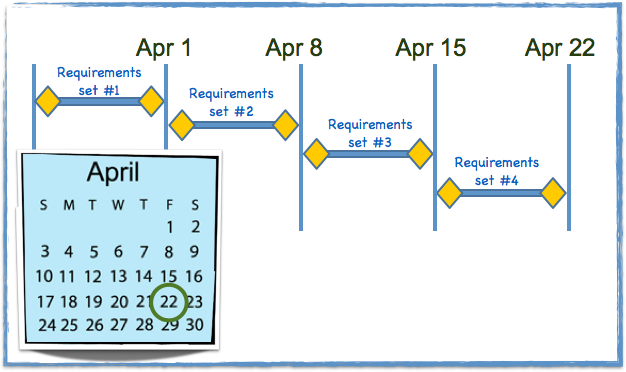

A Schedule Math Question

The first set of requirements slips one day.
Predict the project end date.

The Agile Alternative

Backlogs and Velocity

Backlogs

  • Client maintain a backlog of user stories
    • most valuable stories first
    • points added by developers

Velocity

  • Sum of points for stories done in last iteration
    • Done means "tested and deployed"
    • No partial credit!
    • Don't average over previous iterations
  • Remaining points ÷ velocity = how many iterations needed to finish

Velocity Charts

  • Simple visualizations of progress in story points
  • Each iteration:
    • Subtract points for stories done
    • Add and subtract points for stories added and removed from backlog
    • Plot

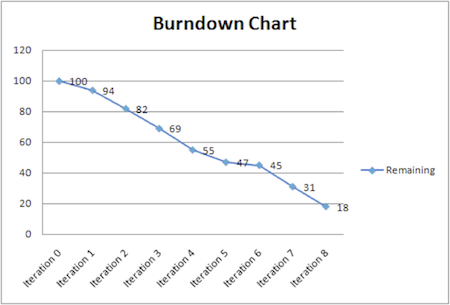

Burn-Down Charts

http://rapidapplicationdevelopment.blogspot.com/2008/10/forget-burndown-use-burnup-charts.html
  • Plot remaining points
  • Use most recent velocity (not average) to predict completion

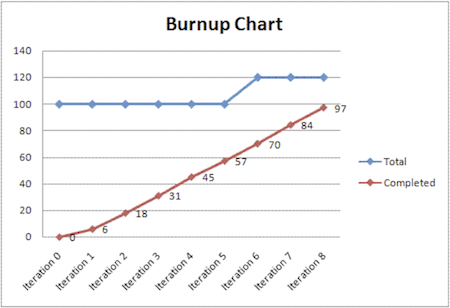

Burn-Up Charts

http://rapidapplicationdevelopment.blogspot.com/2008/10/forget-burndown-use-burnup-charts.html
  • Each iteration: plot total points in backlog, total points completed
  • Shows interaction of scope and true velocity
  • The only line you can control is scope

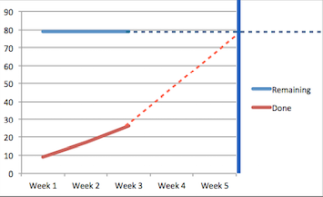

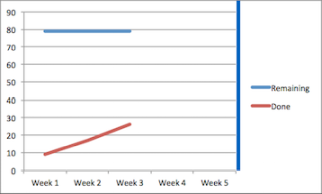

When Scope is Too Big

Velocity does not meet scope in time
Miss deadline?
Rush to finish?

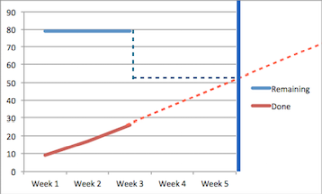

Reduce scope.

Burnup Tool

Velocity without graphs

Burndown charts are look nice and are popular, but they suggest a numeric precision that doesn't exist.

An alternative is to focus just on what stories are likely to get done.

Here's a way to do that

Here's a template spreadsheet

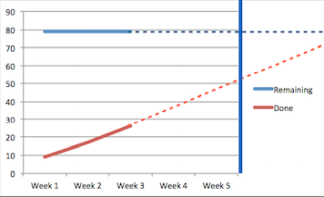

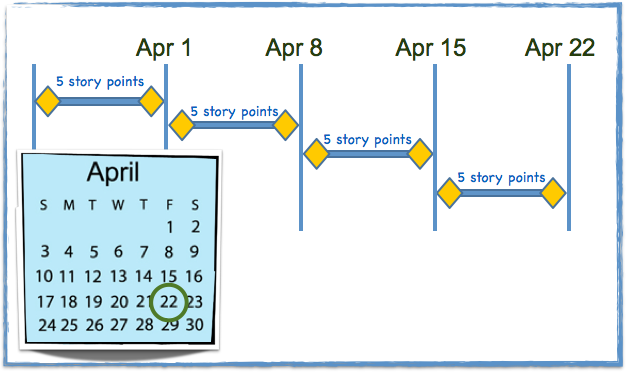

Schedule Math Revisited

The first set of requirements slips one day.
Predict the project end date.

Velocity Math

20 total points in backlog, predicted velocity is 5.
4 points are actually done in Iteration 1.
Predict the project end date.

But, But, But

At Last, Answers

  • When will the project be done?
    Whenever you say it must be done
  • How are things going?
    It's all on the velocity charts!
  • How many people do you need?

Thanks to Hakim El Hattab for RevealJS
